Storefront vs Curtain Wall: Which Facade Suits Your Building?
They look similar from the street but solve different problems. When a retail storefront system is the right call — and when the project has quietly outgrown it.

- Storefront = ground-floor glazing up to ~2 stories, panel-replaceable and budget-friendly; curtain wall = a tested building envelope.
- If glazing climbs past the second floor or spans between floor slabs, the project has outgrown storefront framing.
- Glass decisions: 10-12 mm tempered for doors and displays, 24-32 mm insulated units where the space is conditioned.
- All drilling and notching happens before tempering — a confirmed panel schedule is the schedule.
- South- and west-facing shops need low-E glazing to protect merchandise and HVAC budgets.
The Ground-Floor Question
Walk any shopping street and you'll see both: slim aluminum-and-glass storefront systems wrapping shops and restaurants, and full curtain wall climbing the towers behind them. They can look nearly identical on the ground floor — but they are engineered for different heights, loads and budgets, and choosing the wrong one costs either money (overkill) or inspections (underkill).
The confusion is understandable: the same glass, similar slim framing, sometimes even the same door hardware. But the two systems answer different questions — a storefront answers 'how do we wrap ground-level retail quickly and affordably', while a curtain wall answers 'how do we make the whole building weather-tight, thermally efficient and structurally sound as an envelope'. Budgets, schedules and maintenance plans follow from which question the project is actually asking.

What Defines a Storefront System
A storefront is a ground-floor glazing system: aluminum framing, typically 1-2 stories maximum, glazed with standard tempered or insulated glass panels, designed for fast installation and easy panel replacement. Entrance doors, sidelites and display windows integrate in the same framing line. Hardware economics matter — a shopfront gets touched, pushed and abused thousands of times a day, so doors and closers are the real specification fight.
The engineering envelope tells the same story: mullion depths of roughly 50-150 mm, anchor spacing in the 3.5-4.5 m range, and deflection limits tuned for ground-level wind exposure rather than the pressures a 20th-floor panel sees. Because every panel is individually framed and replaceable, a cracked lite becomes a one-hour swap instead of a façade intervention — a maintenance property that matters as much as the initial price for retail landlords.

What Defines a Curtain Wall
A curtain wall is a building-scale envelope: engineered for multi-story spans, floor-line anchors, water/air penetration testing at pressure, and thermal movement across tall elevations. Systems are priced and tested as assemblies. For full comparison, see our curtain wall systems guide — this article is about the decision boundary between the two.
That testing is the honest dividing line. A curtain wall system carries documented water-penetration, air-leakage and structural performance at design pressure — evidence a storefront system is never asked to produce, because it never faces the same loads. Stick-built, unitized or semi-unitized, the shared principle is that the envelope is designed as a continuous skin across many floors, with stack joints accommodating live thermal movement that ground-level glazing simply never experiences.

How to Tell Which One the Project Needs
| Project trait | Storefront | Curtain wall |
|---|---|---|
| Height | Ground floor to 2 stories | Any height, floor-supported |
| Span between anchors | Up to ~3.5-4.5 m | Engineered per floor |
| Wind load demand | Moderate, ground-sheltered | High, increases with height |
| Thermal performance | Standard IGU in frames | Thermally broken systems, tested |
| Panel replacement | Fast, individual panels | Module or panel per system design |
| Budget tier | Lower | Higher |
Inside a Storefront Glass Package
A complete package is more than panels — every hole and edge is decided before the tempering furnace, which is why the sequence matters:
- Panel schedule review: we check every panel against the framing drawings for size, build-up and glass pocket fit before anything is cut.
- Cutting and edgework: seamed edges for hidden rebates, flat-polished for door panels and any exposed edge.
- Drilling and notching before tempering: hinge holes, patch-fitting cut-outs and lock preparation are machined at this stage.
- Tempering to EN 12150 / ANSI Z97.1 with per-batch fragment testing and certificates for each order.
- IGU assembly where insulated units are specified: dual-seal edge system, warm-edge spacer, argon fill on request.
- Export crating with per-panel labels matching the panel schedule, so site crews install without re-sorting or measuring.
The Details That Make or Break a Storefront
- Glass: 10-12 mm tempered or 24-28 mm insulated units; insulated glass pays for itself wherever the space is conditioned.
- Solar control: south/west-facing shopfronts benefit from low-E coatings — merchandise fades and HVAC bills climb otherwise.
- Entry integration: automatic sliding or swing doors need reinforcing in the header — design the framing around the door package, not after.
- Canopies and signage bands: coordinate a glass canopy and sign soffits with the same framing system for a coherent street presence.
- Full aluminum door-and-window packages for upper floors come as aluminium windows and doors systems.
Before ordering replacement glass, measure the existing glass pocket depth and width — the frame system, not the glass, decides the maximum build-up. Send those two numbers and we confirm what fits, including whether an insulated upgrade is possible.
Where the Money Actually Goes
The table explains why misclassifying a project hurts in both directions. Specifying curtain wall on a two-story retail unit buys testing and engineering the building does not need; forcing a storefront system onto a four-story elevation fails quietly in deflection, water management and thermal movement, then loudly in inspections.
| Cost line | Storefront | Curtain wall |
|---|---|---|
| Framing system | Standard extrusions, stocked profiles | System-engineered, project-tested assemblies |
| Glass | Standard tempered and IGU sizes | Coated lite sourcing, larger lites, higher spec |
| Installation | Ground-level crews, fast cycles | Cranes, rigging, floor-line anchors |
| Testing | Component level, limited scope | Water and air penetration tests at pressure |
| Future maintenance | Single panels swapped from inside | Module or unit-level replacement per design |
Five Mistakes Retail Projects Make
- Ordering door glass without confirming the hardware brand — patch-fitting hole patterns differ between framing systems.
- Skipping low-E on conditioned stores to save upfront, then paying it back monthly in HVAC and faded merchandise.
- Using single-glazed display windows in heating climates — condensation on winter mornings reads as neglect from the street.
- Specifying 10 mm tempered for very large panels where wind load calls for 12 mm — span and wind, not habit, set thickness.
- Leaving transom and signage-band glazing out of the glass package, then paying a local shop for mismatched panels later.
Wind Load, Deflection and Why Height Changes Everything

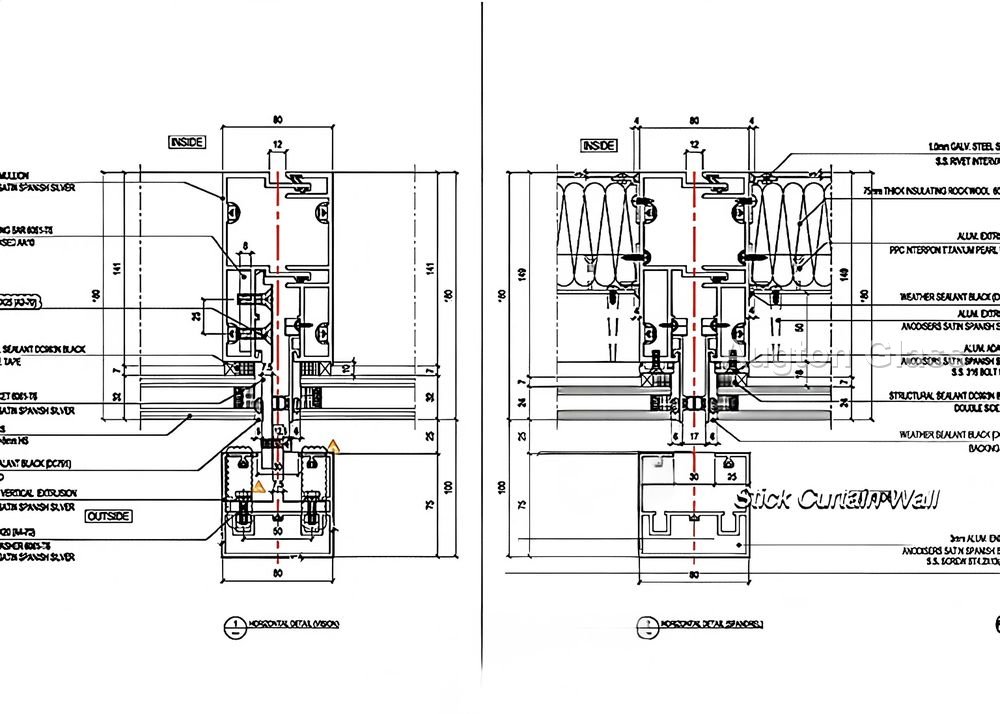

Design wind pressure grows with height above ground — a panel 40 floors up can face two to three times the pressure of the same panel at street level, and the framing must carry that difference plus inter-story drift when the building sways. This is why the glass itself is rarely the deciding factor: 10 mm tempered works in either system, but the anchorage, mullion section and joint design do not transfer from one to the other. When a two-story retail corner is later extended upward — a common renovation story — the correct move is not bigger glass in the storefront system but a floor-supported engineered solution.
Height does not change the glass; it changes everything that holds the glass.
A Practical Rule of Thumb
If the glazing stays within two stories, hangs on a ground-floor slab, and can be replaced panel by panel from inside — it's a storefront, and a storefront system will be faster, compliant and cheaper. The moment the vision climbs past the second floor or spans between floor slabs, the project has crossed into curtain wall engineering, and the glass schedule should be engineered (and tested) accordingly.
Frequently Asked Questions
Can storefront glass be insulated?
Yes — modern storefront systems accept 24-32 mm insulated units in the same framing. Insulated tempered units are the default where the space is air-conditioned or heated.
What glass thickness do shopfronts use?
Display windows and doors typically use 10-12 mm tempered glass; insulated units use two 6-8 mm tempered panes. The frame system's glass pocket defines the accepted build-up.
How do I reduce heat and fading in a south-facing shop?
Specify low-E insulated glass and consider a laminated outer lite for UV blocking — standard PVB filters 99% of UV, protecting merchandise even where solar heat is handled by the low-E coating.
Can you match an existing storefront framing system?
Yes — send the framing manufacturer's technical sheet or measure the glass pocket, and we will supply replacement panels to the exact build-up, including drilled door panels.
Do you supply complete storefront glass packages for export?
Yes — panels, door glass, sidelites and transoms, drilled and edged per the framing drawings, crated for export. Typical production is 10-15 days after drawing approval.
What certification comes with storefront glass?
Tempered panels are produced to EN 12150 or ANSI Z97.1 with per-batch test documentation, and insulated units follow EN 1279 for edge sealing and gas fill. Drilled and notched panels are tempered after machining, so the certificate covers the finished product. Certificates ship with each order for permit submission and main-contractor records.
Can a single broken panel be replaced years later?
Yes — that is the core advantage of storefront systems. Send the panel schedule or a photo with dimensions; we remake the panel to the original build-up, drilled and edged to match, typically within 10-15 days. Keeping the original panel schedule on file makes reorders a one-email job, which is why we label every crate to match that schedule.
The Bottom Line
Send the elevation drawings or panel schedule — we will quote the full storefront glass package and flag any panels that need curtain wall engineering.
